Where does that starting number actually come from?

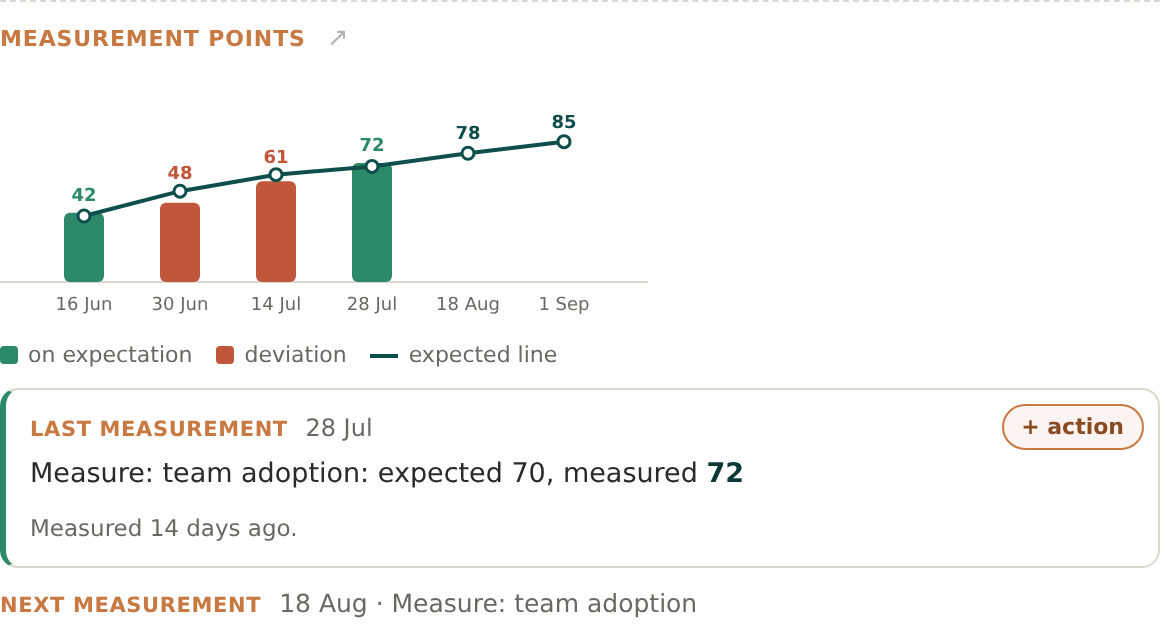

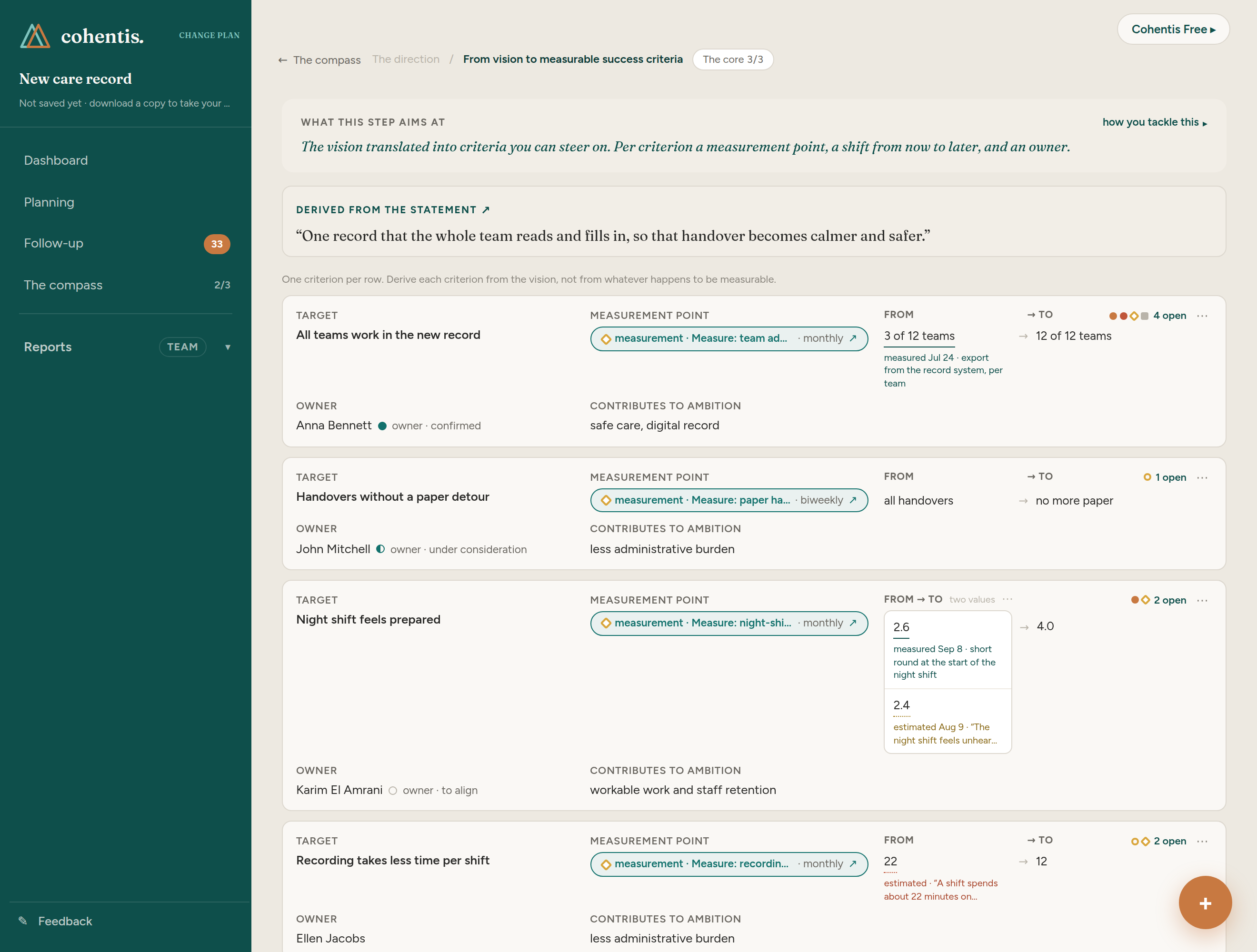

Every success criterion has a from and a to. From now on the app asks one question when you type a number: did you count it, or are you estimating? Both are fine, and an estimate that says it is an estimate is worth more than a measured number nobody can explain. If you counted it, you write down how: which group, which question, how the answers became one value.

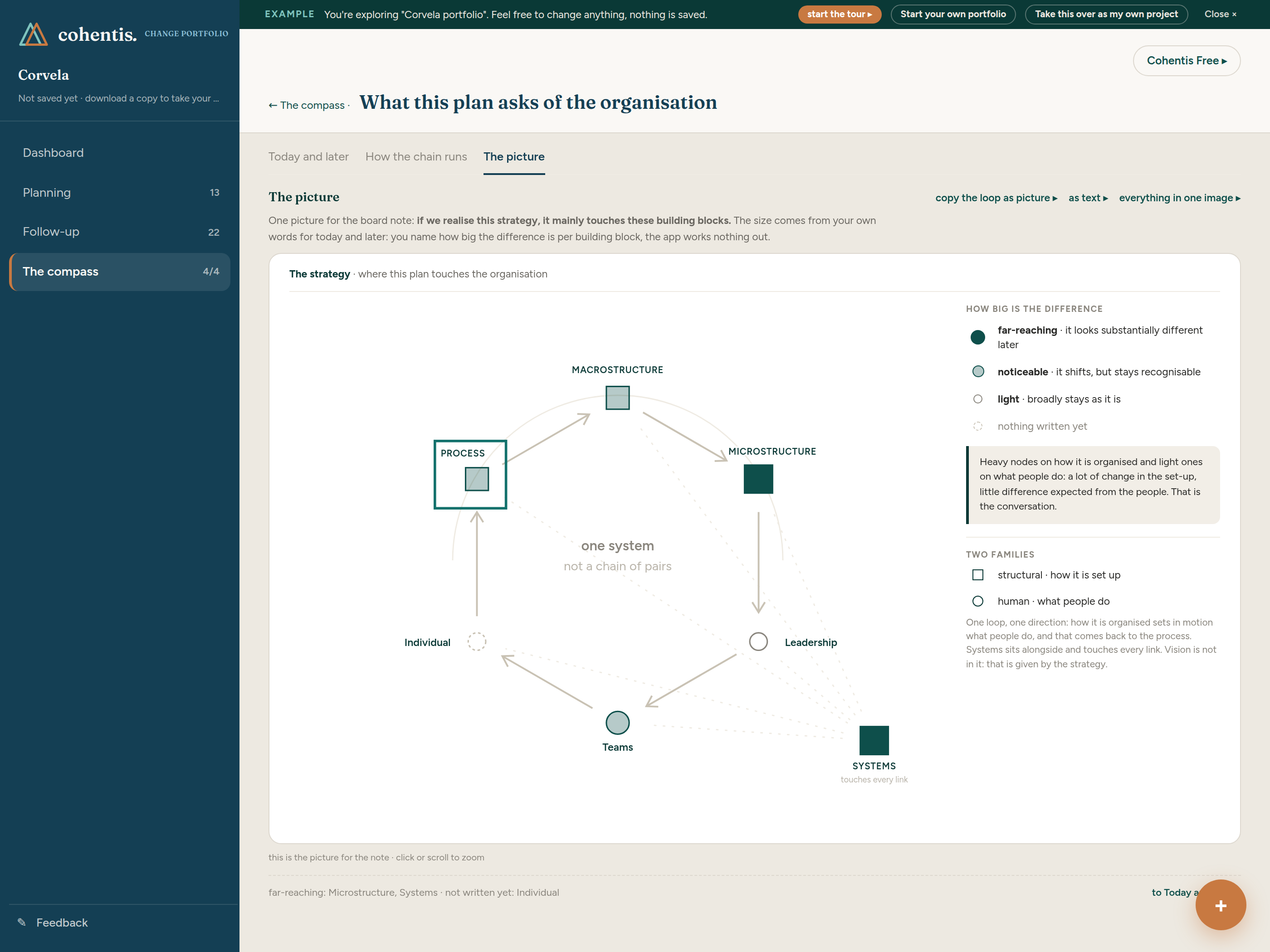

Every benefit now points at the objective it serves
A success criterion in a change plan can be linked to a lever in the portfolio: the capability the organisation wants and does not have yet. What the change manager measures travels back to the objective it was about, with the date and the plan it came from. Nothing is overwritten silently. If two plans report a different value for the same lever, the portfolio manager decides which one lands.
One table with every benefit across every initiative
What was promised, where the starting point came from, and where it stands today. One line per benefit, not per initiative, because a plan rarely delivers one thing and collapsing them into a single line is what makes the question unanswerable. Sort it by objective for the board, or by what it rests on to see how much of your portfolio runs on belief.
And what the sponsors would bet on it
Before a benefit can be measured, someone has to believe it will land. The portfolio manager now walks five questions with the sponsor. Is the problem recognised, is the benefit measurable, is it technically possible, can the organisation absorb it, will the behaviour hold? The answer is written down in the sponsor's own words, with how sure they are. The lowest answer decides, because a benefit with four strong answers and one hunch is a benefit with a hunch underneath it.
How change portfolio management works →
